Recycling infrastructure is in a build cycle unlike anything the industry has seen. Extended producer responsibility (EPR) laws are now enacted in six US states covering packaging, container deposit schemes are expanding in Europe and Australia, and the US EPA has set a national recycling rate target of 50% by 2030. The result: municipalities, waste haulers, and private investors are all trying to build material recovery facilities (MRFs) at once — and hitting a wall of 18–30 month conventional construction timelines and soaring steel and labor costs. Modular prefabricated construction changes the equation by building the MRF as factory-manufactured structural modules: sorting halls, baler rooms, tip floors, and administration wings arrive as steel-framed modules and are set in weeks rather than seasons. This guide covers the MRF building program, equipment integration, and the cost and phasing math that makes modular delivery attractive for recycling programs. The process-equipment pattern parallels modular water and wastewater treatment facility construction.

Modular recycling center exterior, large prefabricated industrial building with sorting hall and baler room modules, steel frame structure visible, module seams on facade, recycling trucks at tipping area, clean geometric lines, dark navy structural steel with warm steel orange accents, no people, no text

The MRF Building Boom

The demand drivers are structural, not cyclical. The EPA reports that the US recycling rate has stagnated near 32% for a decade while waste generation grew to 292 million tons per year; meeting the 2030 target requires roughly 100–150 new or expanded MRFs nationally. EPR laws in California, Oregon, Colorado, Maine, and Minnesota require producers to fund collection and processing infrastructure, creating a wave of publicly tendered MRF projects. Meanwhile, the equipment inside a modern single-stream MRF — optical sorters, eddy current separators, ballistic separators, and balers — has a 10–15 year replacement cycle, meaning the building must be designed for equipment retrofit from day one. Conventional MRF construction suffers from the same disease as all heavy industrial building: sequential trades, weather exposure, and a critical path measured in years. Modular delivery compresses the building schedule so the equipment installation — the real heart of the facility — starts sooner.

Types of Material Recovery Facilities

MRFs come in three basic configurations, and the building program differs for each:

Across all types, the building is a clear-span industrial structure with a tipping floor, a sorting mezzanine, a baler room, and outbound bale storage — plus administration and employee welfare spaces. The clear-span industrial envelope is the same building type covered in modular industrial warehouse construction, extended with process-specific modules.

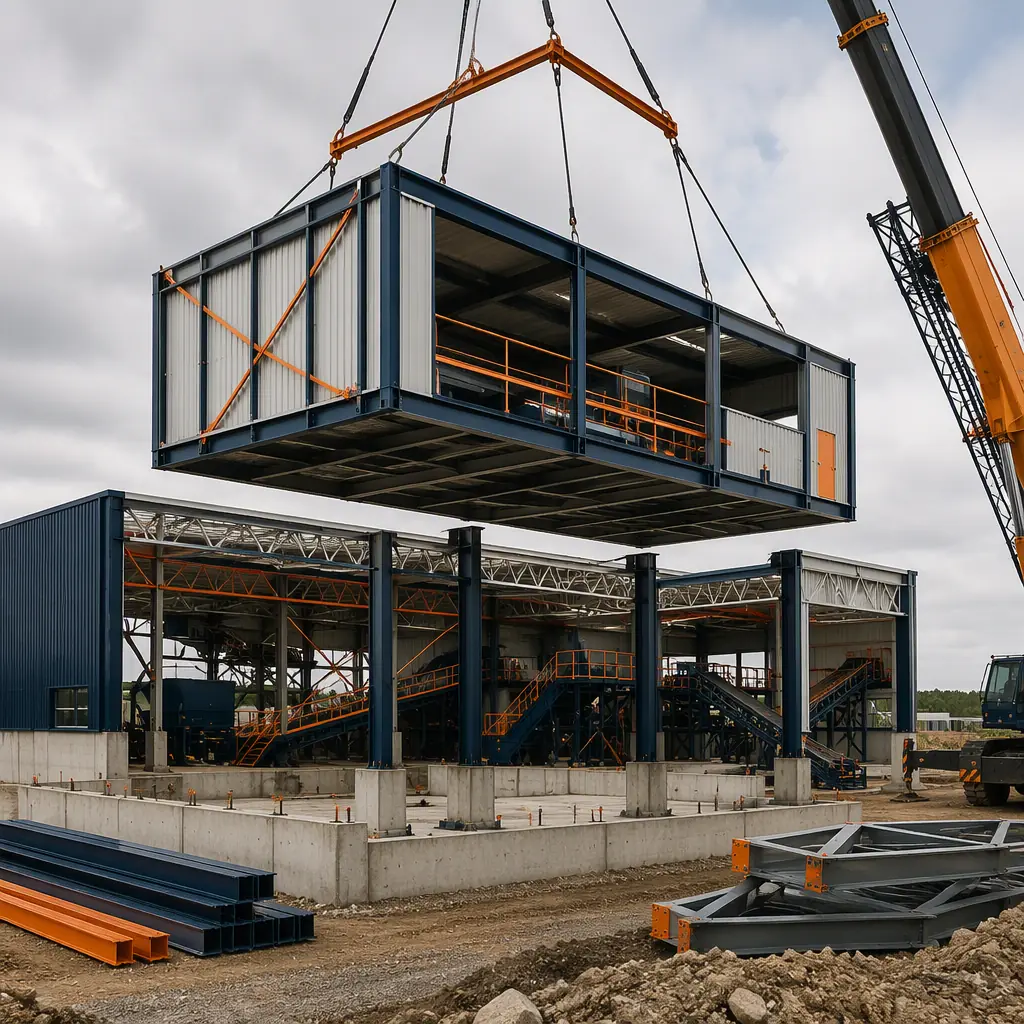

Crane lifting large prefabricated steel-frame industrial module onto concrete foundation at recycling facility construction site, modules being positioned with module seams visible, clear-span sorting hall under assembly, dark navy structural steel with warm steel orange accents, no people faces

The Modular MRF Building Package

A modular MRF is assembled from factory-built structural modules that map directly to the process zones:

The factory-build discipline that makes this work — tolerances, QC, and integration — is the same system documented in modular factory QC systems.

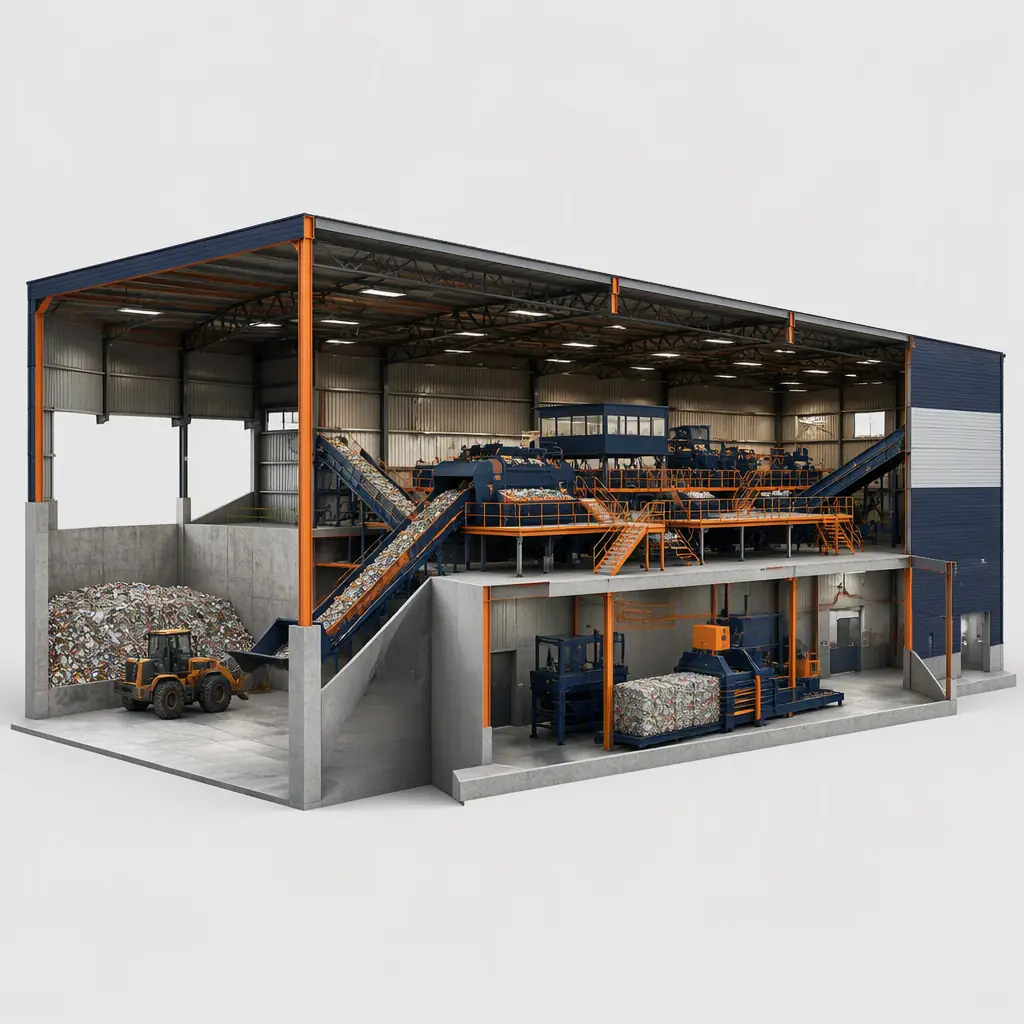

Photorealistic 3D cross-section render of modular recycling facility sorting hall, steel truss structure with conveyor sorting line, optical sorter, baler room and tipping floor, clean engineering visualization showing clear-span interior, module seams, no text, no labels

Equipment Integration — Sorting Lines, Balers & Conveyors

The building is the servant of the equipment in an MRF, and modular delivery inverts the conventional relationship: instead of building the shell and then fitting equipment into whatever space exists, the modules are engineered around the equipment layout. Conveyor runs, sorter positions, baler pads, and mezzanine levels are defined at design stage, and the module frames are fabricated with the embeds, penetrations, and structural supports the equipment needs. Factory coordination with the equipment vendor means chutes, electrical raceways, and compressed air lines are pre-positioned rather than field-modified. The integration planning mirrors the process-heavy approach in modular heavy industrial construction, and the mechanical systems follow modular MEP integration.

Cost & Timeline — Modular vs. Conventional MRF

ItemConventionalModular
Building design & engineering$0.8–1.5M / 4–6 months$0.5–1.0M / 2–3 months
Building construction (100,000 sq ft)$18–28M / 14–20 months$15–23M / 6–9 months
Equipment (sorting line, balers)$6–15M / installed after shell$6–15M / installed in parallel
Site work, foundations & utilities$2–4M / sequential$1.8–3.5M / parallel with factory
Total Program$27–49M / 24–30 months$23–43M / 10–14 months

The 12–15% capital saving matters, but the schedule is the headline: a facility that starts processing 12–18 months earlier converts a 200-tpd MRF's roughly $8–15 million annual revenue (at $35–60 per ton processing revenue plus commodity value) into 1–2 extra years of operation within the same funding round. Program economics follow the framework in our 2026 modular cost guide.

Factory floor of modular prefabricated industrial construction facility, large steel truss module for recycling sorting hall under assembly, workers installing insulated wall panels, overhead crane, assembly line, dark navy and warm steel orange accents, no people faces

Environmental & Safety Compliance

MRFs sit under a dense compliance stack that modular construction turns into factory-documented facts. Dust control is regulated (occupational exposure limits and neighborhood nuisance rules), so the building's dust-collection system is engineered into the modules with ducting pre-installed. Fire risk from baled materials and hydraulic systems drives sprinkler and suppression design, factory-installed and tested. Stormwater from the tipping area — which can carry leachate and litter — must be contained and treated, so the tip floor drainage is embedded in the module design rather than added as a retrofit. The environmental engineering pattern is the same one documented in modular water and wastewater treatment construction, and the embodied-carbon advantages of factory-built steel are quantified in our embodied carbon guide.

Phased & Expandable Design

Recycling programs grow in predictable steps — collection contracts expand, EPR obligations ramp up, and commodity prices shift — so the best MRF designs phase capacity. A modular facility can open with a 150-tpd single line and add a second sorting line, additional balers, or a full building extension as tonnage grows, because each addition is another module purchase with the same design language, foundations, and crane plan. This mirrors the expansion logic in modular building additions and expansions and the phasing strategy in modular construction project timelines. Public owners also benefit from the procurement path: modular delivery fits RFP structures that value schedule certainty and fixed pricing, covered in our RFP and procurement guide.

Is a Modular MRF Right for Your Program?

Modular delivery delivers the strongest value for MRFs with hard opening deadlines (EPR compliance dates, grant spend-down periods), for programs that need to retrofit equipment over a 10–15 year life (the module design accommodates future equipment changes), and for sites where winter weather or a thin local trades market would stretch a conventional schedule. For a small drop-off center or a simple transfer station with minimal processing, conventional construction may be simpler. For the standard 100–500-tpd single-stream MRF — tip floor, sorting hall, balers, and administration — modular construction compresses the building phase from the industry's longest lead time into the fastest, most predictable part of the program, with the equipment integration engineered in the factory rather than improvised in the field.
