Approximately 185,000 retail fueling stations operate in the United States, with an estimated 35-40% requiring major renovation or replacement within the next decade due to aging underground storage tanks (USTs), outdated canopy structures, and accelerating EV charging integration. Traditional gas station construction takes 16-24 weeks from groundbreaking to fuel dispenser commissioning. Modular prefabricated fueling station construction compresses this to 8-12 weeks by manufacturing canopy structures, convenience store modules, and EV charging bays in a factory while site excavation and UST installation proceed in parallel. For a major fuel brand rolling out 20 station rebuilds per year, modular delivery recovers millions in accelerated forecourt revenue. With 60+ modular fueling stations already deployed by Shell, BP, and Circle K, the modular approach is proving that retail energy infrastructure can be built faster, safer, and at 30-40% lower total project cost than conventional methods.

Modern modular gas station canopy, steel frame prefabricated structure with fuel islands beneath, clean geometric design, module seams visible, factory-assembled construction, dark navy structural columns, warm steel orange accent details on canopy edges, no people, no traditional gas stations

The Modular Fueling Canopy: Prefabricated Steel Structures Engineered for Retail Energy

The fuel island canopy is the defining architectural element of any retail fueling station — and the single most schedule-critical component in traditional construction. A conventional canopy build follows an 8-10 week sequence of structural steel erection, decking, roofing, electrical rough-in, soffit finishing, and lighting commissioning. Every step is weather-dependent. Modular canopy construction compresses this entire sequence into a factory-built module that arrives on site as a single structural assembly:

A conventional canopy carries approximately $18,000-25,000 in weekly general conditions costs. Eliminating 6-8 weeks of canopy site work through modular delivery recovers $108,000-200,000 in general conditions savings alone — before accounting for accelerated fuel revenue. As detailed in our modular construction cost per square foot guide, these indirect savings frequently exceed the direct labor savings that most developers focus on.

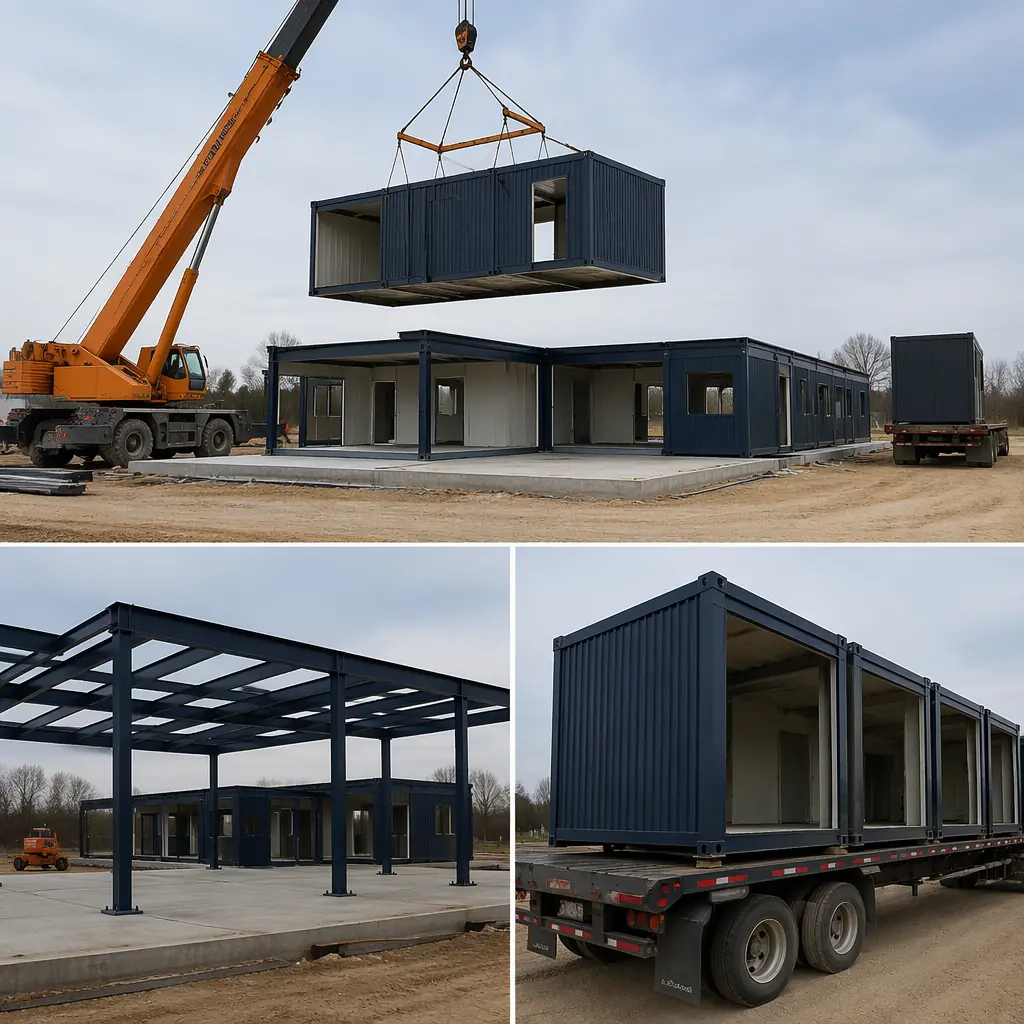

Modular convenience store and fueling canopy being craned into position, station under active construction, steel frame module suspended from crane cable, prefabricated retail unit being placed on prepared foundation, flatbed truck with additional modules in background, construction site with excavation and UST area visible, dark navy and steel orange brand colors on structural elements

Convenience Store Modules: Integrated Retail Operations in a Factory-Built Package

The convenience store is the profit engine of the modern fueling station. NACS data shows fuel generates 60% of station revenue but only 35% of gross profit — the remaining 65% comes from in-store merchandise, food service, and beverage sales. MODURA's modular c-store modules range from 2,400 to 4,800 square feet and arrive as substantially complete retail environments:

The standard module is dimensioned for flatbed transport with inter-module joint systems for larger formats. This modularity enables fuel retailers to standardize their store program across sites with varying lot dimensions while maintaining identical interior layouts. Our coverage of modular retail construction explores how this standardization advantage applies across all retail formats.

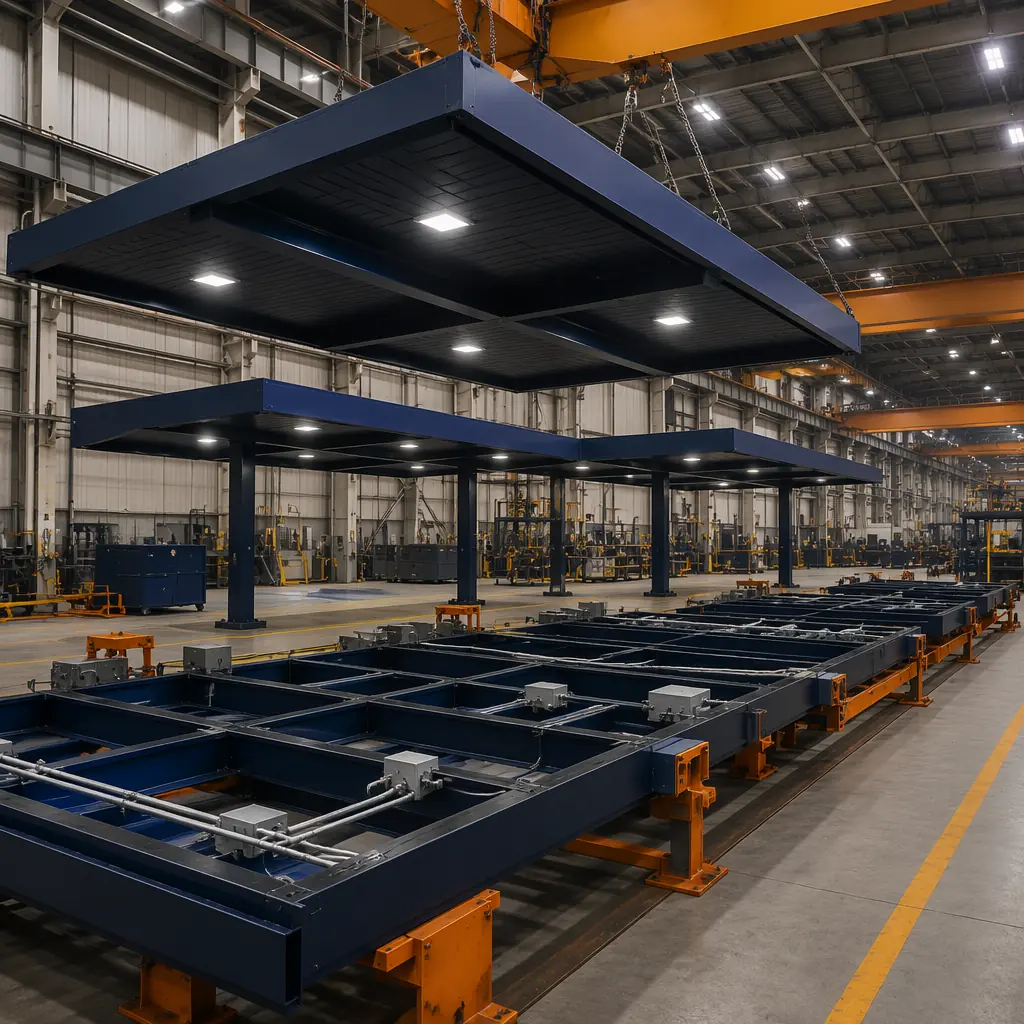

Factory assembly of modular fuel canopy steel frame, production line with canopy modules in various stages of completion, steel I-beams being welded at bolted connections, factory-installed LED lighting fixtures visible on canopy underside, explosion-proof electrical conduit runs pre-installed, overhead crane moving completed canopy module, clean industrial factory environment, dark navy structural steel, warm steel orange accent on fascia edges

EV Charging Canopies: Solar-Ready Infrastructure for the Electric Transition

A DC fast charger delivering 350 kW requires approximately 480V three-phase at 500 amps — equivalent to the electrical demand of a 30,000 sq ft office building at a single parking stall. When a station deploys 8-12 DC fast charging positions, total load can exceed 4 MW, requiring dedicated utility transformers. Modular EV charging canopies are engineered for these demands:

BP's "dual energy" station concept — combining 4 fuel dispensers and 6 DC fast chargers under a single 120-foot clear-span modular canopy — was deployed at 12 locations across the UK and Germany in 2024-2025, achieving 10-11 week deployment per station. As explored in modular construction transportation and logistics, delivering complete canopy modules to constrained urban sites is a decisive advantage over stick-built methods.

Modular EV charging canopy with solar panel integration on canopy roof, electric vehicles charging at DC fast charging stations beneath prefabricated steel frame structure, clean geometric canopy design with photovoltaic panels visible on top surface, modern fueling station forecourt with charger pedestals, dark navy canopy columns, warm steel orange edge trim, modular construction seams visible, no people faces, no traditional gas pumps

Underground Fuel Tank Coordination: The Site-Built Foundation Beneath the Modular Station

While above-ground components are factory-built, the UST system remains site-constructed — and coordinating this interface is the critical engineering challenge. A typical station deploys 2-4 double-wall fiberglass USTs (12,000-20,000 gallons each), connected through 300-500 linear feet of double-wall piping per EPA 40 CFR Part 280. The modular construction sequence coordinates this through precise dimensional control:

  1. Week 1-3: Tank pits excavated, USTs placed and ballasted, piping trenches dug. Dispenser sumps positioned via GPS survey referenced to factory-set canopy column coordinates, achieving ±1/2 inch alignment.
  2. Week 4-5: Piping pressure-tested to 50 psi with EPA tightness verification. Backfill compacted to 95% modified Proctor density under dispenser areas.
  3. Week 6-7: Concrete spread footings poured at canopy column and c-store module locations, with a 12-inch crawl space for utility connections.
  4. Week 8-9: Modules delivered by flatbed and craned into position. Dispensers set on pre-positioned sumps and connected via flexible connectors.
  5. Week 10-12: UST precision testing repeated post-placement. Fire marshal, health department, and building department inspections proceed concurrently.

MODURA performs a 3D laser scan of the completed UST installation (±2mm accuracy) and overlays this point cloud against the factory BIM model in Autodesk Navisworks. Dimensional conflicts are resolved before modules leave the factory — not discovered with a 40,000-pound module suspended 20 feet in the air. This BIM-to-field coordination, detailed in modular construction BIM and digital workflows, separates successful modular fueling station programs from those that encounter costly field rework.

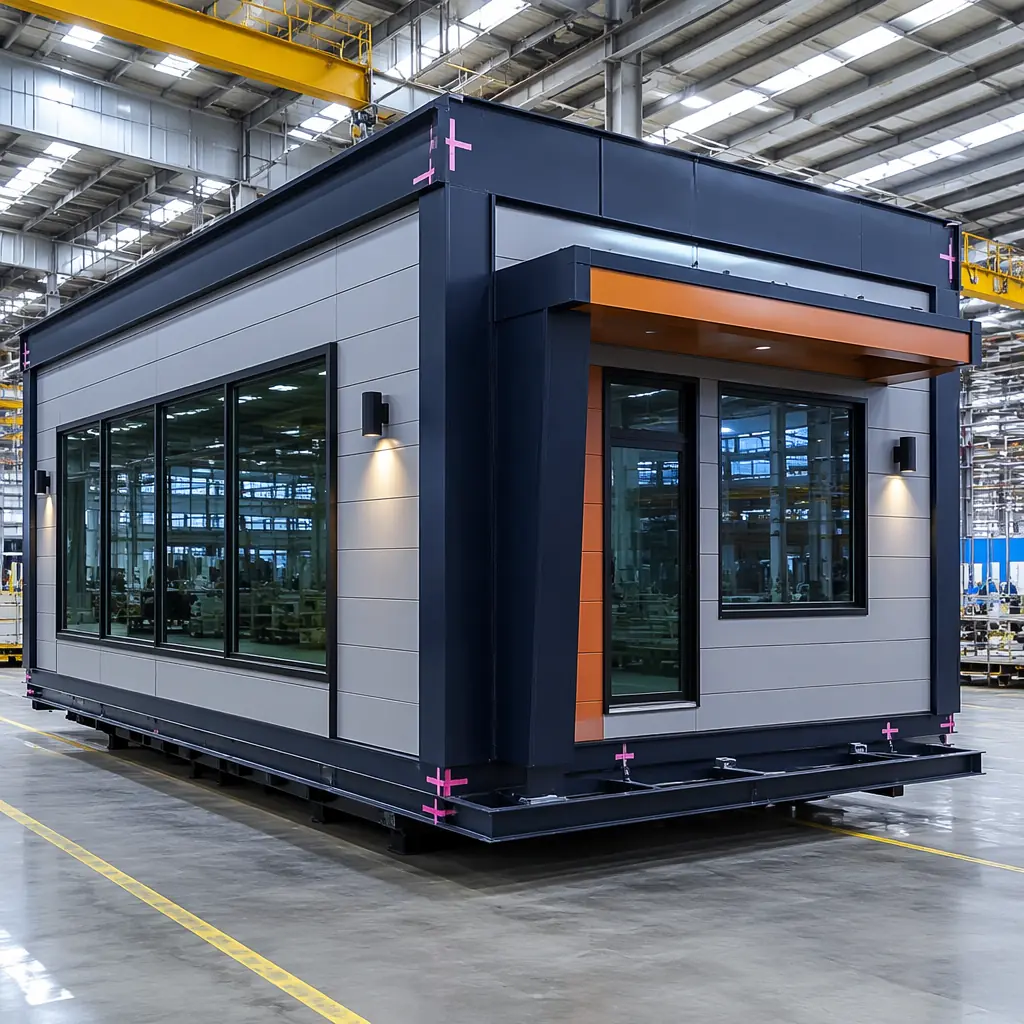

Modular convenience store module on factory floor, prefabricated retail unit nearing completion, exterior cladding installed, storefront glass window frames in place, module being inspected by quality control, factory lighting illuminating the completed c-store module, clean industrial manufacturing environment, dark navy exterior panels, warm steel orange trim accents, module ready for transport to site

ICC and NFPA 30A Compliance: The Regulatory Framework for Modular Fueling Stations

Fueling stations operate under IFC Chapter 23 and NFPA 30A, imposing requirements on construction materials, electrical classification, ventilation, spill containment, and emergency shutdown. Modular construction satisfies these through factory-controlled quality assurance rather than field inspection alone.

Structural Fire Resistance: IFC Section 2306

IFC 2306.2 requires buildings at motor fuel dispensing facilities maintain minimum 10-foot separation from dispensers. Modular c-store modules use 1-hour fire-resistance-rated exterior walls (5/8-inch Type X gypsum on 6-inch steel studs with mineral wool insulation, tested per ASTM E119) where walls are within 10-20 feet of dispensers. The UL-designated assembly is factory-installed with certified documentation rather than relying on field interpretation.

Electrical Classification: NFPA 30A Chapter 7 and NEC Article 514

The three-dimensional hazardous location zone around dispensers is addressed at the modular design stage: all conduit routing, fixture placement, and junction box locations are pre-coordinated against classification envelopes. Factory records document every explosion-proof seal pour with date, technician ID, and pressure test result — documentation fire marshals increasingly expect at plan review for multi-station programs.

Emergency Shutdown: NFPA 30A Section 6.7

Modular stations pre-wire the 24VDC supervised emergency stop circuit with break-glass stations at each dispenser island and cashier station, function-tested at the factory and again after site connection. This dual-test approach satisfies the growing fire marshal expectation for both factory and field verification of safety systems.

The modular compliance documentation package — compiling every UL listing, fire-rated assembly test report, and factory pressure test record — reduces plan review durations by 3-4 weeks compared to site-built stations where documentation is assembled ad hoc from subcontractors. As shown in modular construction permitting and zoning, factory documentation is one of the most underappreciated advantages of the modular approach across regulated building types.

Real-World Deployment Data: 60+ Modular Fueling Stations and Counting

As of mid-2026, more than 60 modular fueling stations have been deployed globally, providing statistically significant performance data:

The aggregate data establishes a clear baseline: modular fueling stations deploy in 50-60% of conventional timeframes, with 30-40% lower total project costs. Factory quality control reduces post-occupancy defect rates by approximately 60% in the first three years. These outcomes mirror the program-level advantages documented across modular industrial warehouse construction and modular data center deployment.

Completed modular gas station, professional architectural photograph, modern prefabricated fueling canopy with integrated LED lighting, convenience store building with glass storefront, clean geometric lines and module grid pattern visible on building facade, forecourt with fuel dispensers beneath canopy, professional dusk lighting showing illuminated station, dark navy structural elements, warm steel orange accent details, brand-compliant color palette, no people

The retail energy sector is at an inflection point. Fuel margins compress as EV adoption accelerates, and the traditional gas station business model evolves toward a combined fuel + electric + convenience + food service format demanding faster, more capital-efficient construction. Modular prefabricated fueling stations — with factory-built canopies, integrated c-store modules, and solar-ready EV charging structures — match the speed, quality, and cost imperatives of this transition. For fuel retailers planning station rebuild programs or dual-energy format rollouts, MODURA brings 500+ completed modular projects across 18 countries and 4 ISO 9001/14001 certified factories. Contact our commercial team for a free feasibility assessment including timeline analysis, modular build program options, and cost comparison tailored to your station format.
