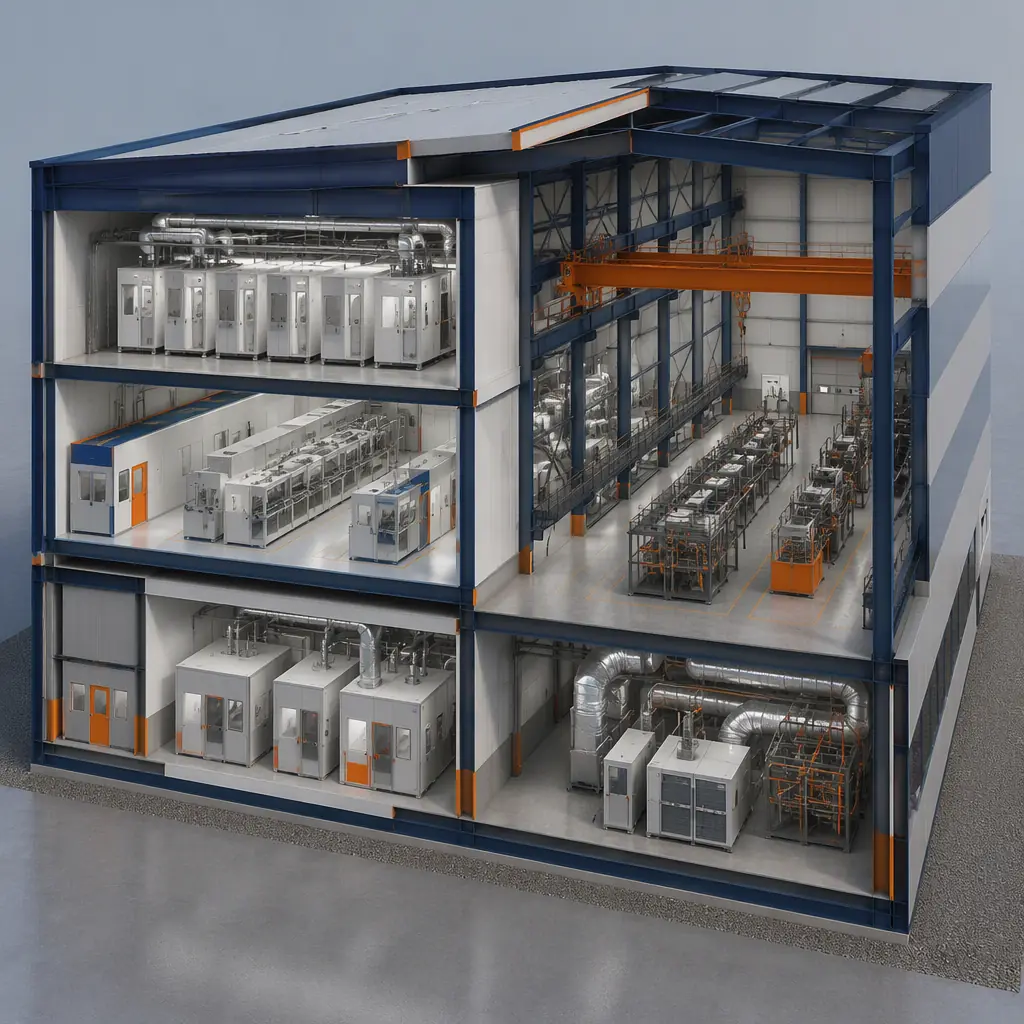

Fuel cell manufacturing is scaling from pilot lines to gigafactories, and the facilities themselves are becoming the bottleneck. A proton exchange membrane (PEM) fuel cell plant converts rolls of membrane material into finished stacks through a sequence of precision steps — catalyst coating, membrane electrode assembly (MEA) lamination, bipolar plate stamping, stack assembly, and burn-in testing — each with its own cleanroom class, humidity band, hazardous area rating and utility requirement. A 50 MW-per-year PEM plant typically occupies 50,000–150,000 sq ft, with the MEA coating line in an ISO 7–8 cleanroom, the stack assembly hall at ISO 8 with strict dew-point control, and the test bay segregated as a hydrogen-permitted hazardous area. Site-built delivery of this mix — cleanroom construction, hazardous area electrical, process gases, DI water loops — routinely takes 18–30 months. Modular prefabricated construction compresses that to 9–15 months: the cleanroom line modules, the assembly hall modules and the test bay modules arrive from the factory with walls, HVAC, utilities and process infrastructure pre-installed, then connect on site in weeks. This guide covers the fuel cell facility program, cleanroom and environmental control, hazardous area design, process utilities, cost structure and delivery phasing — building on the manufacturing-facility methodology we document for modular renewable energy manufacturing facilities and modular cleanrooms for semiconductor facilities.
The Fuel Cell Factory Program: What Ships Inside the Modules
A fuel cell gigafactory decomposes into a small set of repeatable building programs, each of which maps cleanly to a factory-built module set. The MEA production line is the cleanest program: catalyst ink preparation, coating and drying, and MEA lamination happen in an ISO 7–8 cleanroom with tight temperature and humidity control, and the coating line itself arrives as a factory-integrated process module with the web-handling equipment, exhaust and solvent recovery pre-installed. The stack assembly program is a high-bay hall where MEAs, bipolar plates and gaskets are stacked and compressed into finished stacks — typically ISO 8 with dew-point control to protect the membrane. The test and conditioning program is the hazardous core: finished stacks are burned in on hydrogen test stands, so the test bay is a ventilated, gas-detected, explosion-rated area with hydrogen supply, purge and exhaust systems. The balance-of-plant program includes the DI water plant, process gas supply, compressed air, the electrical room with UPS, and the shipping and receiving docks. Each program is a discrete module set, and the room-level engineering follows the factory-built logic we document for modular EV battery gigafactory construction, where process modules with integrated utilities are the standard delivery unit.
Cleanroom & Environmental Control for MEA Production
The MEA is the heart of a PEM fuel cell, and its production environment determines yield. The membrane is a perfluorosulfonic acid polymer that absorbs and releases moisture, so the coating and lamination line must hold a tight humidity band — typically 30–50% RH — and a stable temperature around 20–24°C to keep the web flat and the catalyst layer uniform. Catalyst inks contain platinum or iridium nanoparticles suspended in solvents, so the coating room needs solvent-rated exhaust, explosion protection where vapors concentrate, and a cleanroom classification of ISO 7–8 to keep particulates off the membrane surface. Factory-built cleanroom modules deliver this environment with repeatable precision: the wall and ceiling systems, the FFU (fan filter unit) array, the humidity control loop and the solvent exhaust are all installed and commissioned in the factory, then connected to the site chilled water and exhaust risers on arrival. The cleanroom engineering — air changes, filtration, pressure cascades — is the discipline we document for modular cleanrooms, and the precision environmental control aligns with the requirements we meet for biotech and life sciences facilities.
Stack Assembly & High-Bay Hall Engineering
Stack assembly is where components become product, and the hall must balance cleanroom discipline with heavy automation. A PEM stack contains 100–400 individual cells, each an MEA sandwiched between bipolar plates, compressed under 100–300 psi of clamping force in a press that can be several meters tall. The assembly hall therefore needs a high ceiling — 6–9 meters for the stack presses and automated guided vehicles — plus ISO 8 particulate control, low-humidity air to protect the membranes during handling, and crane capacity for the stack tooling. Modular high-bay modules with integrated steel roof structures deliver the clear span without field-erected structural steel, and the assembly line layout — component kitting, stacking, compression, leak testing, welding — is designed into the module floor plan so the line is ready to receive equipment the day the modules connect. The structural and heavy-equipment engineering follows the methodology we document for modular heavy industrial construction, where floor loading, crane rails and vibration control are engineered into the module frame rather than added in the field.
Hazardous Areas: Hydrogen Testing & Solvent Systems
The test bay is the most safety-critical program in a fuel cell plant. Finished stacks are conditioned and validated on hydrogen test stands, and hydrogen is flammable across 4–75% concentration in air, so the bay is designed as a classified hazardous area: continuous ventilation sized for the worst-case release, hydrogen gas detection interlocked with the HVAC and the hydrogen supply shutoff, explosion-rated electrical equipment, and a pressure-relief path through the roof. The hydrogen supply itself — delivered tube trailers or an on-site electrolyzer — is housed in a separately ventilated enclosure with its own gas detection. The solvent systems for catalyst ink preparation get the same treatment: flammable solvent storage in rated cabinets, solvent-rated exhaust from the coating line, and fire suppression aligned with the process. The hazardous area design — ventilation, detection, zoning and fire protection — is the engineering discipline we document for modular hydrogen refueling stations, where hydrogen safety is engineered into the module rather than bolted on, and the fire-resistance standards align with modular fire safety construction.
Process Utilities: DI Water, Gases & Power
A fuel cell factory is a utility-intensive building. The DI water plant produces 18-megohm water for the coating and testing processes, with storage, recirculation and polishing loops factory-mounted on a skid module. The process gas program covers nitrogen for purging and inerting, hydrogen for testing, and instrument air — each delivered as a factory-built gas module with the regulators, manifolds and gas detection pre-installed. Power is the third utility: a 50 MW-per-year plant typically draws 2–5 MW of connected load, with the electrical room, transformers and UPS factory-integrated into a plant module. Because all of these systems are designed as modules that connect through standardized utility interfaces, the site work shrinks to the incoming power feed, the water supply and the process gas delivery point. The utility engineering — DI loops, gas manifolds, electrical distribution — is the mechanical discipline we document for modular MEP systems integration, where factory-installed systems turn a field-heavy build into a plug-and-play connection, and the energy efficiency of the envelope follows modular energy-efficient building design.
Process Qualification & Clean Energy Compliance
Beyond the physical build, a fuel cell factory must be qualified to produce a certified product, and modular delivery compresses that timeline too. The plant's quality system follows ISO 9001 for manufacturing plus the automotive-grade IATF 16949 framework when stacks supply vehicle programs, with traceability on every MEA lot, bipolar plate batch and stack serial number. The factory-built modules support the qualification audit directly: because the cleanroom classifications, environmental records and equipment installation documentation are generated in the factory, the quality dossier is substantially complete when the modules arrive. Many projects also align with the US Department of Energy's clean hydrogen production standards and the Inflation Reduction Act 45V tax credit requirements for electrolyzer content, which audit the manufacturing facility's provenance and domestic content — documentation that a factory-documented build makes straightforward to assemble. The quality and traceability engineering is the methodology we document for modular factory QA/QC systems, and the certification pathway follows the compliance approach we use for seismic and code compliance in engineered buildings.
Cost Structure — Modular vs. Site-Built Fuel Cell Plants
| Facility Type | Site-Built | Modular |
|---|---|---|
| MEA + stack assembly plant, 30,000 sq ft (10 MW/yr) | $18–28M / 20–28 months | $15.5–24M / 10–15 months |
| Full PEM gigafactory, 100,000 sq ft (50 MW/yr) | $55–85M / 26–34 months | $47–72M / 13–18 months |
| Test bay + conditioning expansion, 10,000 sq ft | $6–10M / 12–16 months | $5.2–8.6M / 6–9 months |
The 10–15% capital saving is secondary to the market math: a fuel cell plant that opens 10–16 months earlier can secure offtake agreements, qualify customers and capture subsidy programs while a site-built competitor is still under construction. For the full cost methodology, see our 2026 modular construction cost guide.
Phasing, Permitting & Delivery
Fuel cell plants are almost always phased, because production capacity scales with market demand and certification timelines. A modular factory can start with the MEA line and assembly hall, begin producing and qualifying stacks, then add test bays, coating capacity and final assembly in later phases — each phase arriving as a factory-built module set connected to the existing utility spine. The delivery schedule is driven by the site pad, the utility connections (power, water, gas) and the equipment commissioning sequence, and the critical-path discipline — factory slots, module sequencing and site readiness — is the scheduling methodology we document in modular construction scheduling. The permitting strategy follows the accelerated path we document for modular construction permitting and zoning, where factory-built structures often qualify for expedited review because the design is documented and repeatable.
Is Modular Right for Your Fuel Cell Manufacturing Project?
Modular delivery creates the strongest value for fuel cell manufacturers building a new facility on a tight offtake schedule, expanding an existing plant with connected capacity modules, or standardizing a factory design across multiple sites. The same factory-built model serves 10,000 sq ft test expansions, 30,000 sq ft MEA and assembly plants and full 100,000 sq ft gigafactories — and because the cleanroom lines, assembly halls and test bays arrive factory-built with utilities and controls pre-installed and tested, the plant is ready to begin process qualification the day the modules are connected and commissioned.
